Deployment of a probabilistic simulation model for predicting demand for acute healthcare in the NHS
27 February 2025
Model Overview
- The baseline data is a year worth of a provider’s HES data
- Each row in the baseline data is run through a series of steps
- Each step creates a factor that says how many times (on average) to sample that row
- The factors are multiplied together and used to create a random Poisson value
- We resample the rows using this random values
- Efficiencies are then applied, e.g. LoS reductions, type conversions
Monte Carlo Simulation
- We run the model N times, varying the input parameters each time slightly to handle the uncertainty.
- The results of the model are aggregated at the end of each model run
- The aggregated results are combined at the end into a single file
Prequisites
- Robust to updated model releases
- Reproducibility- across multiple versions
- Speed- for the model and the reporting
- Interpretation of complex output
Data sources
- The usual rule is that 80% of the work is on data
- Not a problem for us because we’re using trusted, curated data (HES)
- So a mere 80% of our work is on data
- Wait, what?
Data pipelines
- RAP is obviously crucial
- Reproducibility is essential
- Undocumented mistakes severe (there are always bugs 🙂)
- Speed and sharing within the project team
- The original data pipelines were SQL
- Updates took 4 days with frequent hangs and crashes
- They now execute in 30 minutes on databricks

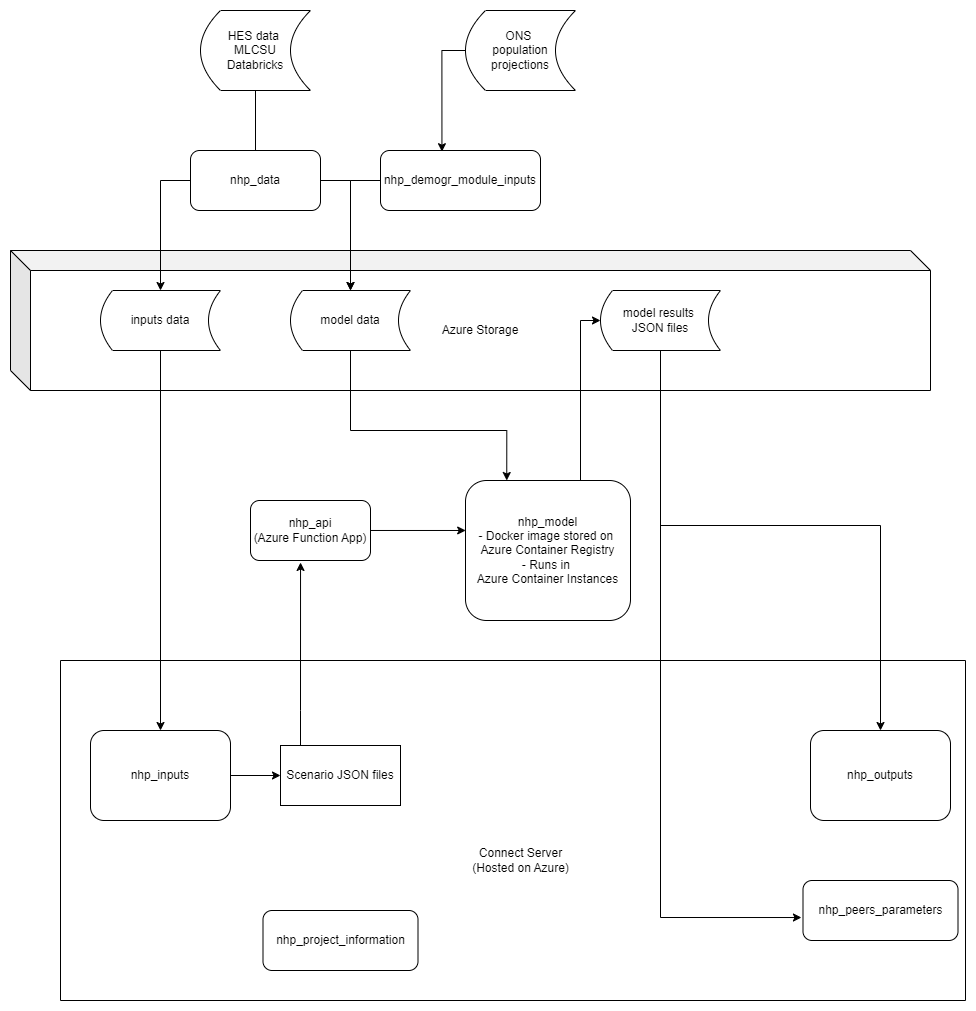

The model itself
- Written in Python for speed
- An API spins up a Docker instance to run the model on demand (~ 5 minutes)
- Uses .parquet, also for speed
- The model outputs row level data conceptually, if not actually
Outputs
- “Final report” Word document, bespoke to current context
- “Outputs dashboard” - containing high level summaries
- Detailed model results - we offer a range of outputs but can always make more
Overview
Uses
- Sizing hospitals
- Sizing left shift
- Predicting, comparing, and monitoring activity mitigation
The process
- January 2023: Development phase
- April-ish: Thinking about deployment
- October-ish: Model is on its way to full production and much remains to do
Operational mode
- The team was growing in November
- There were two priorities
- Increase bus factor (which I’ll come back to)
- Deploy the first production ready version
The first deployed version
- December-ish: Many needs that were not anticipated
- This first release kicked off lots of other work
- The second release kicked off lots of other work
- It was very hard to do any long term planning
Scrum
- We are not doing “proper” scrum
- Product owner, scrum master, everyone else
- Five week sprints with a one week recovery run between each one
- Sprint planning, sprint catchup, sprint retro
Sprint retro
- What went well, what could have gone better, and what to improve next time
- Looking at process, not blaming individuals
- Requires maturity and trust to bring up issues, and to respond to them in a constructive way
- Should agree at the end on one process improvement which goes in the next sprint
- We’ve had some really, really good retros and I think it’s a really important process for a team
What did scrum give the team?
- Simultaneous releases of linked repos
- The team works autonomously in the sprint
- Better conversations about “no”
- The planning and retro process improves the team’s processes, not just the code
Product owner
- My lessson- get out the way
- A better connection between high level and low level planning
- Clear release dates and responsibilities
- Clear what I should be doing
Agility
- This project was agile whether we liked it or not!
- My 2022 agile definition:
- Customers can’t make up their minds
- It’s hard to design software all at once
- Continuous delivery keeps customers happy
- “Welcome changing requirements, even late in development”
- “At regular intervals, the team reflects on how to become more effective, then tunes and adjusts its behavior”
- “Continuous attention to technical excellence and good design enhances agility”
- “Simplicity- the art of maximizing the amount of work not done- is essential”
How scrum helped
- Those shaping the project wanted to be able to make quick changes- and see the long term plan
- Agility is a mindset, a mode of practice
- If anything we were actually too agile
- Being agile is all about being able to review and make decisions frequently
- But it isn’t about changing what you’re doing all the time
- Good code and good teams are ready to change direction- whether they change or not
Current work and future
- Work on a “population based” model
- Providing support to elicit parameters for local and national use
- More work understanding and building on the activity avoidance parameters
